1 PARCEL · SUBMITTED JAN 30, 2020

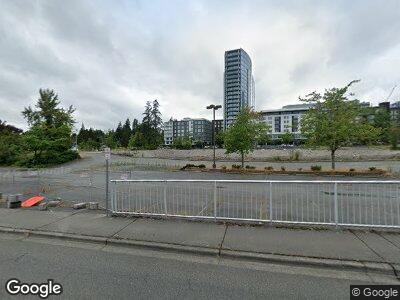

100 112th Ave NE
Photo taken July 2024

100 112th Ave NE

Downtown, Bellevue, WA 98004
Land useCommercialOfficeRetail
Design Review
Issued Sep 21, 2023
Land Use
Issued Sep 21, 2023
Construction
Completed

Permits

11 PERMITS · 4 STAGES
Design review4 PERMITS
26 103995 LDUnder ReviewAPP COMPLETE FEB 18, 2026

Application to ADR Reissuance to Align Permit Expiration with the 21 122609 LP. Per Bellevue Land Use Code LUC or Code 20.30V.190 the City approved extended vesting for the Project specifically. 10-year Master Development Plan vesting through September 21, 2033 and 6-year Administrative Design Review vesting through September 21, 2029., 21 132031 LD

20 102773 LDCanceledAPP COMPLETE JAN 30, 2020

This proposal is for a multi-phase, full-block development on the site bounded by 112th Ave NE, NE 2nd, 114th Ave NE and Main Street in downtown Bellevue. The project is a two-phase Master Development Plan (MDP).

The Phase 1 development will be a 17-story Class-A office building, a 5-story for-rent residential building, both over 5 levels of below grade parking. There will be 377,507 GFA of office and 123,019 SF of residential, combined with ground floor uses consisting of 16,435 SF of retail. The northern portion of the site will be dedicated to an enhanced through-block connector along the east-west axis of the site, connecting 112th Ave NE to 114th Ave NE.

The Phase 2 development will be a 17-story Class-A office building and a 15-story Class-A office building with 5 levels of below grade parking that will connect to Phase 1. In total, there will be 609,633 GFA of office, combined with ground floor uses consisting of 17,923 SF of retail

21 132031 LDClosedAPP COMPLETE NOV 12, 2021 · ISSUED SEP 21, 2023

New development of 4 towers at approx. 250 max height with approx. 1.1 million sf of usable area.

21 121880 LDCanceledAPP COMPLETE OCT 08, 2021

New development of 4 towers at approx. 250 max height with approx. 1.1million sf of usable area. This will be a 2 phase project.

Land use3 PERMITS
20 102776 LPCanceledAPP COMPLETE JAN 30, 2020

This proposal is for a multi-phase, full-block development on the site bounded by 112th Ave NE, NE 2nd, 114th Ave NE and Main Street in downtown Bellevue. The project is a two-phase Master Development Plan (MDP).

The Phase 1 development will be a 17-story Class-A office building, a 5-story for-rent residential building, both over 5 levels of below grade parking. There will be 377,507 GFA of office and 123,019 SF of residential, combined with ground floor uses consisting of 16,435 SF of retail. The northern portion of the site will be dedicated to an enhanced through-block connector along the east-west axis of the site, connecting 112th Ave NE to 114th Ave NE.

The Phase 2 development will be a 17-story Class-A office building and a 15-story Class-A office building with 5 levels of below grade parking that will connect to Phase 1. In total, there will be 609,633 GFA of office, combined with ground floor uses consisting of 17,923 SF of retail.

21 122216 LPCanceledAPP COMPLETE OCT 15, 2021

New development of 4 towers at approx. 250 max height with approx. 1.1million sf of usable area.

21 122609 LPClosedAPP COMPLETE OCT 25, 2021 · ISSUED SEP 21, 2023

New development of 4 towers at approx. 250 max height with approx. 1.1 million sf of usable area.

Construction1 PERMIT
22 106027 BVCanceledAPP COMPLETE APR 25, 2022

Shoring permit for the south half of the project site for a proposed development of 4 towers at approx. 250 max height with approx. 1.1 million sf of usable area.

Demolition3 PERMITS
22 127124 BECanceledAPP COMPLETE OCT 25, 2022

Demolition of 3 existing buildings to grade to be able to make way for new development of 4 towers at approx. 250 max height with approx. 1.1 million sf., 21 132031 LD

23 105882 BEClosedAPP COMPLETE MAR 24, 2023 · ISSUED MAY 18, 2023

Demolition works of the three existing structures on site. Scope will include structures only, no site demolition. Structures will be demolished down to their base slabs and stop. Utilities will be capped at grade., 21 132031 LD

23 105887 BEClosedAPP COMPLETE MAR 24, 2023 · ISSUED APR 26, 2023

The soft gut includes the removal of all non-structural items, finishes, walls and infrastructure. The abatement works will cover interior of all three structures and the exterior of the Azteca. Soft gut and abatement scope for each structure will be completed before any demolition occurs on that respective structure., 21 132031 LD

Permit data from City of Bellevue

The full project page

3 sections · with Pro

More about 100 112th Ave NE

  • The land and its zoningPro
    Each parcel with its lot size, assessed value and zoning
    1 parcel
  • Sales historyPro
    Recorded sales of this property, with the date and price of each
  • Press coveragePlus
    News articles about this project, with the date of each
